Industriestrasse Süd renewal
Location Stadt Zug
The starting point
Industriestrasse Süd in Zug was comprehensively renovated. During the construction period of around 20 months, some 1,000 households were directly or indirectly affected by the work. Because of the long project duration, numerous construction phases and changing traffic routing, there was a high need for information among residents and other road users.
The project at a glance
With the renovation of Industriestrasse Süd, a busy urban street space was comprehensively renewed over a longer period. The work was carried out section by section and required recurring adjustments to the construction sequence and traffic routing during delivery. Given the central location and the large affected area, continuous construction site communication that could be updated flexibly was particularly important.
- Construction volume
CHF 7.5 million
- Construction period
April 2024 – December 2025
- Construction phases
9 phases
Our solution
With BDFcivory, all relevant project information was bundled centrally and kept up to date throughout the construction period. Particularly important were fast communication of adjustments, a clear presentation of the construction phases and ongoing information on traffic routing and restrictions. At the same time, usage and reach could be evaluated continuously.
-
Central project information
Project description, construction phases, contacts and current information were bundled on one central platform.
-
Broad digital reach

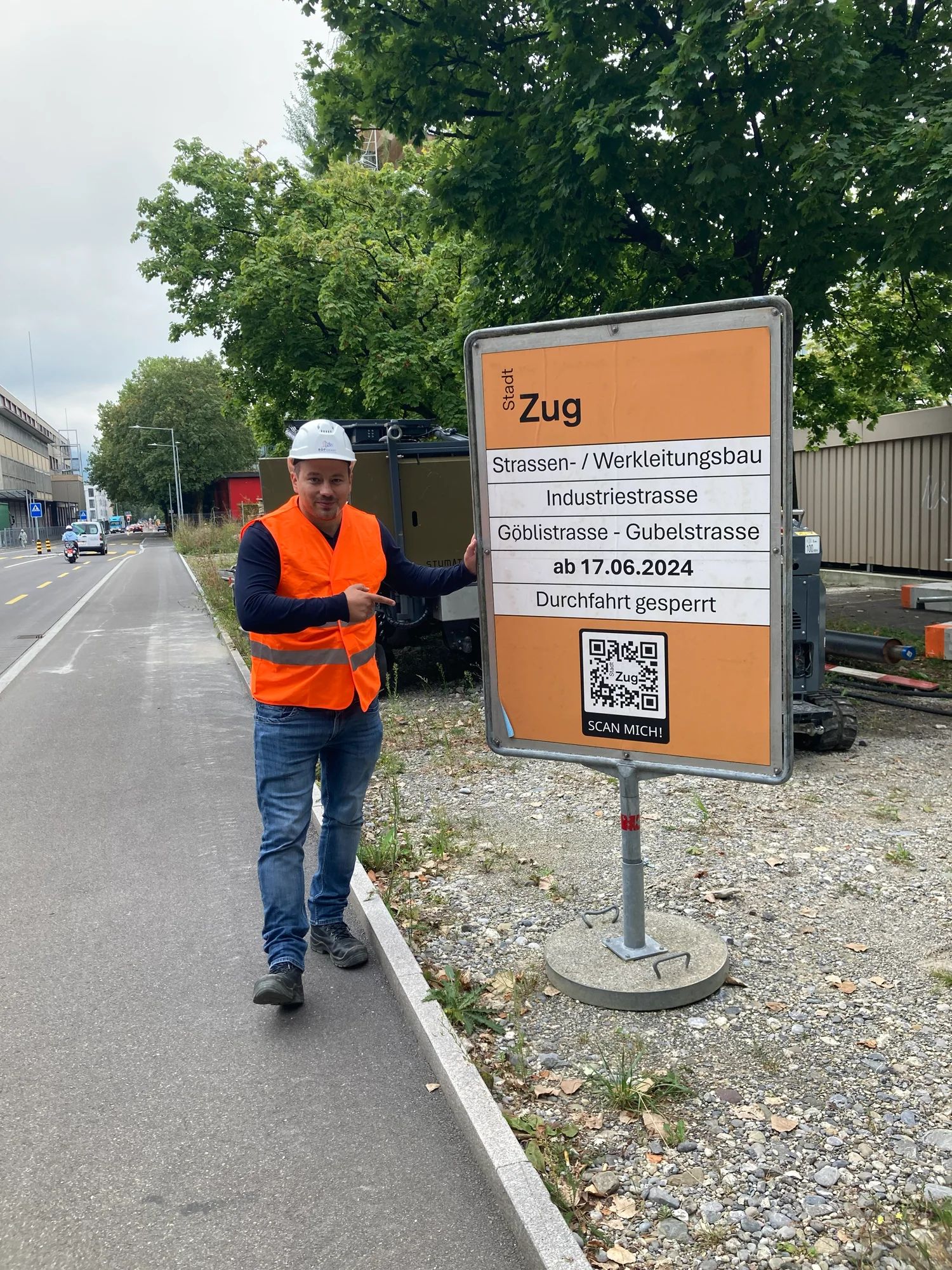

The public was directed to the digital project information via letters to residents, site boards, the website, press releases and social media.
-
Construction site news over a long project period
A total of 28 construction site news updates were sent during the construction period to keep people informed about changes and the current project status.
-
Visualisation of the construction phases
The construction sequence and individual phases were presented clearly and updated whenever changes occurred.
-
Tracking & evaluation
Usage, reach and feedback from the public and project stakeholders were evaluated over the entire project period.
Impact in numbers
Feedback from practice
Feedback from the public and project stakeholders on this project.
Residents
Would you like to be informed digitally about construction projects again in future?
- Yes, with a digital solution
- 98 %
- No, with a letter to residents
- 2 %
Project stakeholders
Would you use the solution for future projects?
- Yes, as standard
- 67 %
- Yes, for certain projects
- 33 %
- No
- 0 %
BDFcivory on the construction site
Throughout the construction period, BDFcivory was continuously supplemented with up-to-date construction site news, project updates and insights from the site. This allowed residents and others affected to follow the progress of the work and keep up to date whenever changes occurred.

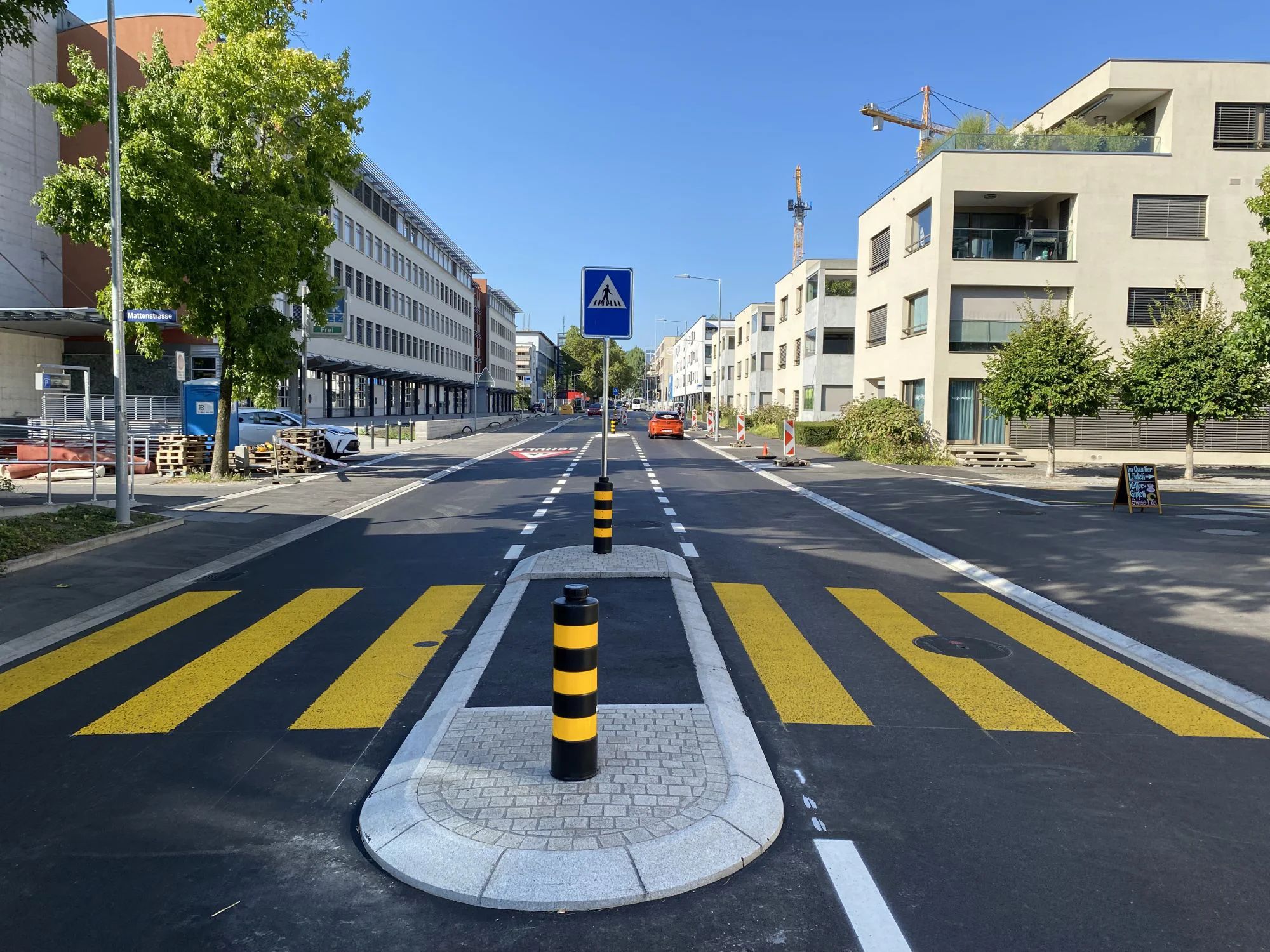

Construction phases and restrictions at a glance

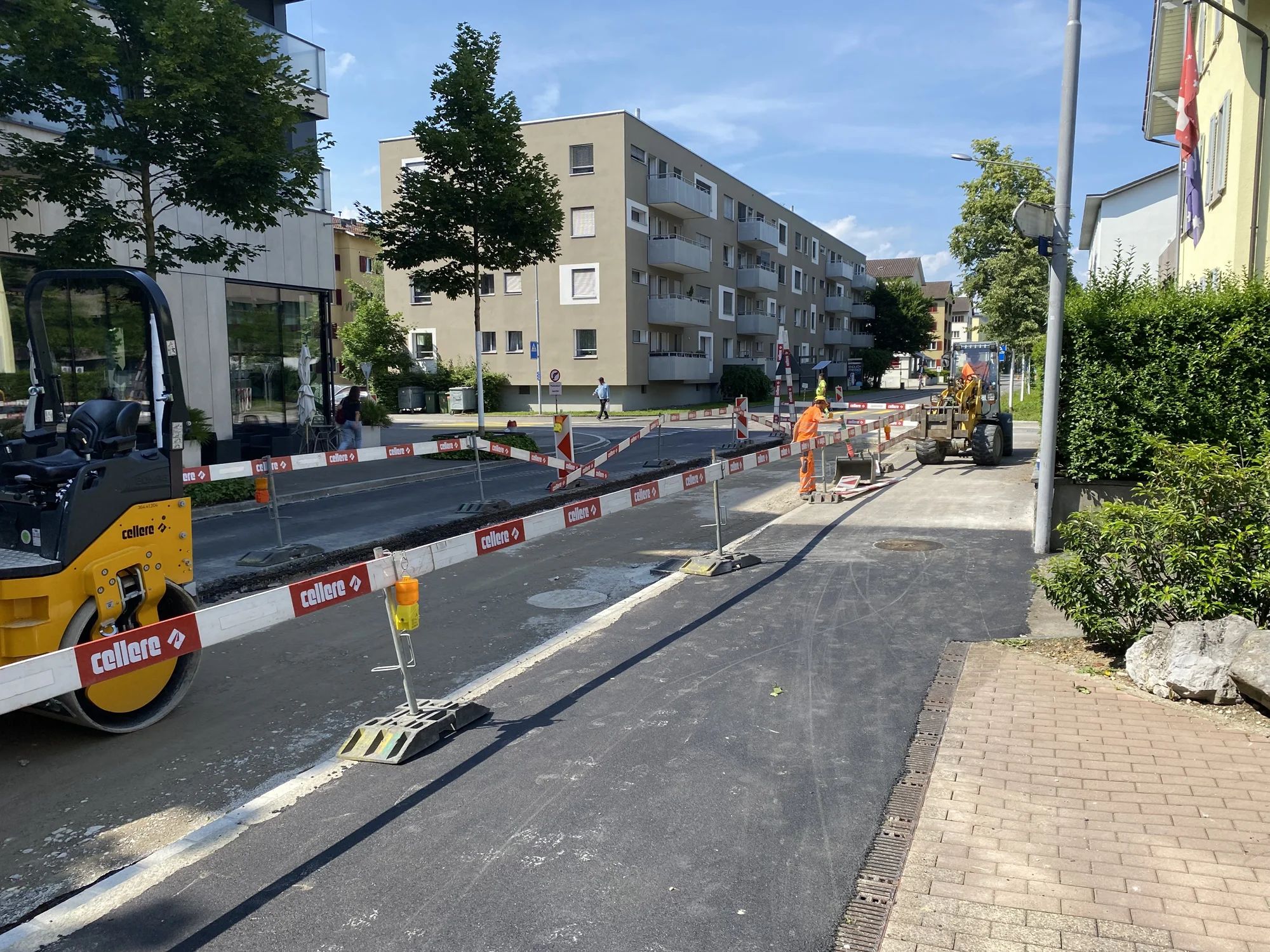

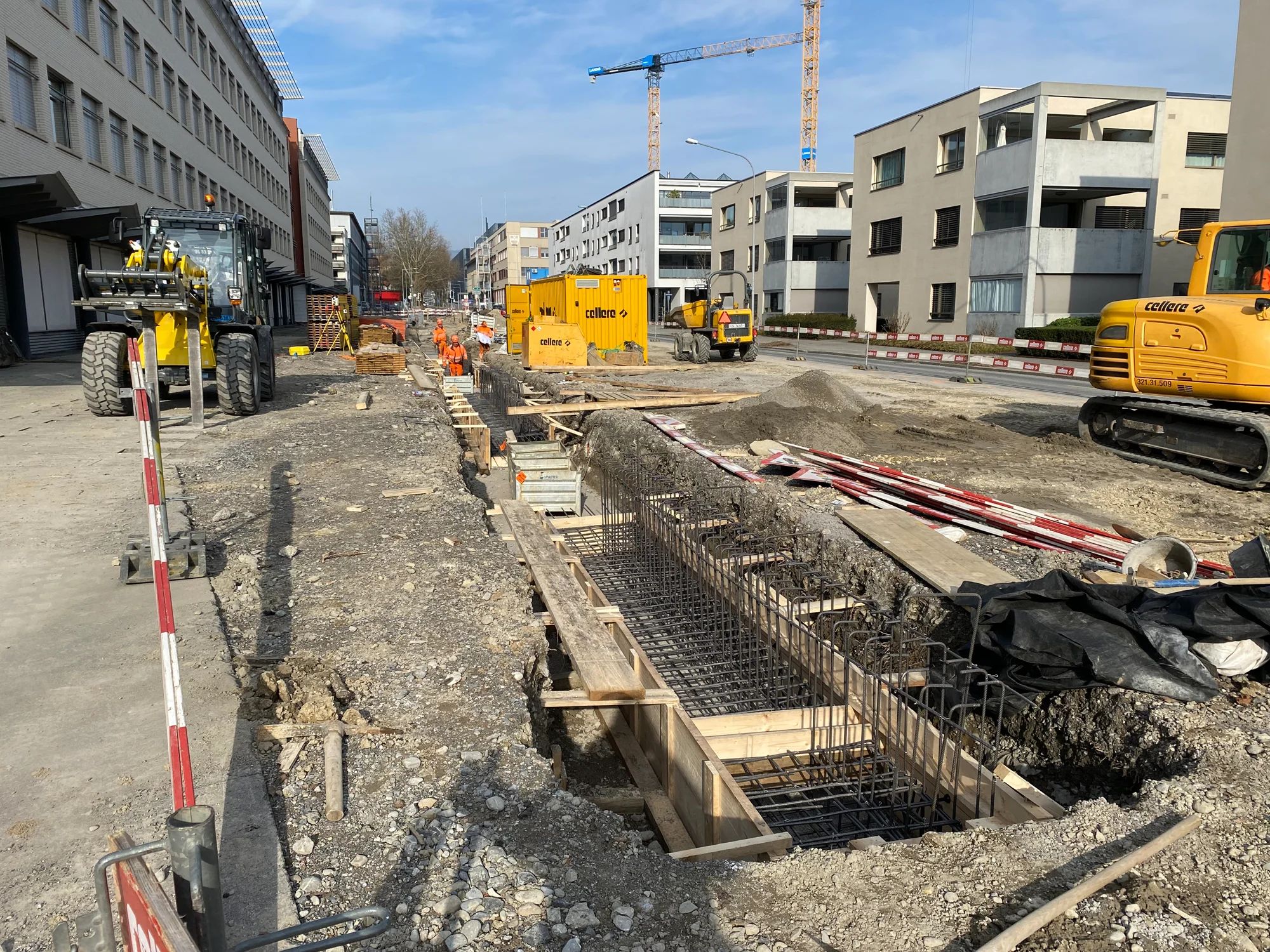

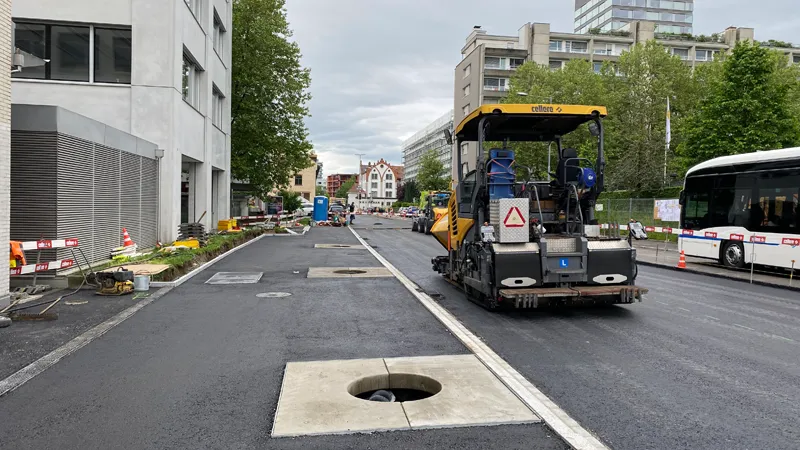

The individual construction phases and traffic routing were continuously prepared digitally and updated whenever changes occurred. This allowed residents and others affected to find out at any time about the current state of the works, upcoming restrictions and adjusted traffic routing.
Experience BDFcivory live
See how BDFcivory was used in the renovation of Industriestrasse Süd. The digital project site shows construction phases, construction site news, visualisations and ongoing project information from practical use.
